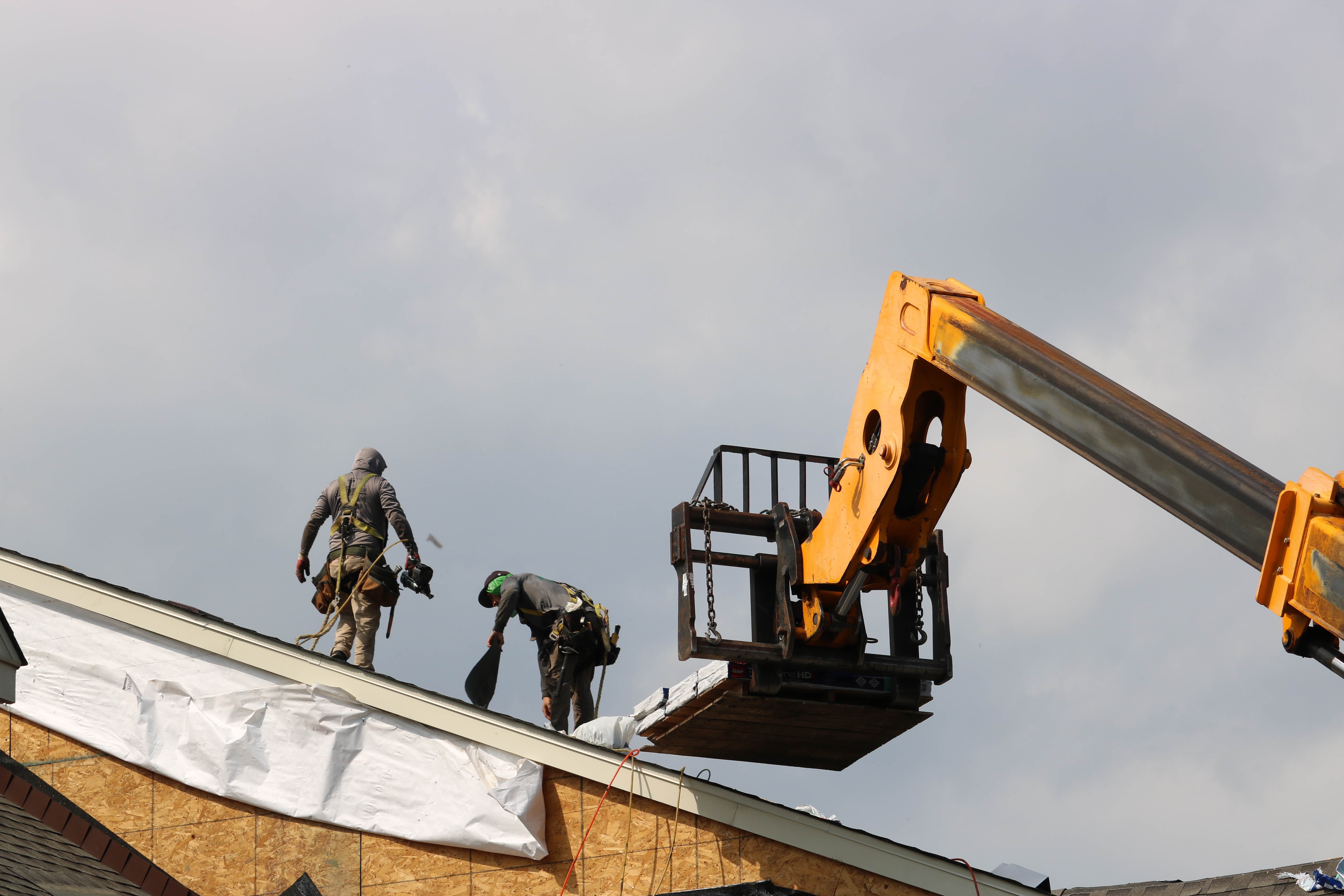

The Villas at Five Ponds Roof Replacement: Protecting 280 Homes Through Careful Planning, Steady Communication, and Community-Wide Coordination
Project Timeline: March 2025 – November 2025
Replacing one residential roof requires planning. Replacing roofs throughout a 280-home active-adult community is something else entirely. The work spreads across streets, shared driveways, occupied homes, landscaped grounds, resident entrances, parked vehicles, and daily routines that do not disappear simply because construction has begun. Materials have to move. Crews need room to work. Residents need clear information. At the end of each day, the community still needs to feel like a neighborhood rather than a roofing yard with mailboxes.
That was the scale facing Lemus Construction at The Villas at Five Ponds in Warminster, Pennsylvania. The community includes 280 carriage homes arranged within approximately 70 residential buildings. Some villas sit beside the rolling grounds of Five Ponds Golf Course. Others extend across Route 132 along Fairway Drive, Villa Drive, Clubhouse Lane, and Five Ponds Drive. The property also includes a large clubhouse, pools, walking paths, recreational amenities, and carefully maintained common grounds.
For residents, this is home. For the association, it is a substantial shared asset with hundreds of roofs that must age, perform, and eventually be replaced under one coordinated plan. Lemus Construction was selected to manage that work through a community-wide roof replacement program completed from March through November 2025.
A Two-Year Contractor Selection Process
The project did not begin with a rushed vote or a quick comparison of three numbers at the bottom of three proposals. According to a letter from The Villas at Five Ponds Executive Board, the five-member board spent approximately two years interviewing and evaluating three roofing contractors recommended by the community’s management company. The board selected Lemus Construction after examining more than price alone. Its decision considered:
- Flexible payment terms without interest
- References from other communities
- Positive feedback from those references
- A professional resident presentation and question-and-answer session
- An advance study of the community’s roofs
- Office staffing available to respond to resident concerns
- The ability to dedicate two full roofing crews
- GAF contractor credentials
- Warranty protection
- Weekly written project updates
- A commitment to complete the community within one construction year
That level of review matters on a project of this size. A roofing contractor is not simply being hired to install shingles. The association is selecting a temporary operating partner who will move through the community for months. The board needed confidence that the company could manage the roof work, resident communication, scheduling, cleanup, warranty documentation, and the inevitable details that surface once construction leaves the conference room and reaches the first building.
Studying the Roofs Before Construction
Approximately one year before the planned work, Lemus Construction conducted a study of the community’s roofs to document existing conditions. That preliminary review was performed without charging the association or obligating it to hire Lemus for the eventual project. This gave the board a clearer understanding of the roofing portfolio before construction began. For a large HOA, that type of early assessment can help establish priorities, support reserve planning, and reduce the risk of building a project around assumptions. A large capital improvement project is easier to manage when the association understands what it owns.
Roof age alone does not tell the full story. Different elevations may weather at different rates. Trees, sun exposure, wind patterns, ventilation conditions, past repairs, drainage paths, and construction details can influence how individual roof sections perform. The advance review helped move the conversation away from vague concerns and toward a structured community plan.
Organizing Roofing Across a Large Community
The Villas at Five Ponds consists primarily of quad-style carriage homes, with four residences arranged within each building. These homes range from roughly 1,800 to 2,400 square feet and include oversized garages, patios or decks, and larger roof areas than many attached-home communities. That scale meant each building required substantial labor, careful material staging, and reliable ground protection before work could move forward. Project Manager Wilson coordinated several Lemus field teams, while two full roofing crews worked steadily through the property from March through November, weather permitting. Keeping that pace required close coordination among Lemus Construction, The Villas at Five Ponds Executive Board, Continental Property Management, Property Manager Amy Wert, field supervisors, roofing crews, and residents. Rather than turning the entire community into one sprawling construction zone, the project advanced through planned sections. This allowed the team to better control deliveries, demolition, installation, cleanup, parking instructions, and resident communication around each active work area. The objective was simple: keep the project moving without letting the neighborhood feel like chaos wearing a safety vest.
Installing a Coordinated GAF Roofing System
The project records identify Weathered Wood as the selected shingle color and a GAF Golden Pledge warranty as the association’s warranty tier. The Weathered Wood blend provided a neutral, established appearance that worked across the community’s masonry, siding, trim, landscaping, and golf-course setting. The GAF roofing system was installed as part of a coordinated replacement approach intended to improve protection across the affected buildings while maintaining a consistent architectural appearance throughout the association.
Project Details
- Community: The Villas at Five Ponds
- Location: Warminster, Pennsylvania
- Property type: Active-adult HOA community
- Homes: 280
- Residential buildings: Approximately 70
- Roofing manufacturer: GAF
- Shingle color: Weathered Wood
- Warranty: GAF Golden Pledge
- Construction period: March through November 2025
- Primary project manager: Wilson
- Property management: Continental Property Management
- Property manager: Amy Wert
- Field staffing: Two primary roofing crews with supporting team members
Protecting Homes and Residents During Construction
The association’s board specifically noted the conduct of the roofing crews during the project.
According to the board’s letter, windows and siding were protected while roofing work was underway. The grounds were cleaned and swept for nails daily. Traffic disruption remained limited, and the board reported no significant issues affecting the community. That is not a small footnote.
Roof replacement is demolition conducted directly above occupied homes. Old shingles, nails, underlayment, flashing, packaging, and sections of deteriorated material all have to come down before the finished roof can go up.
On a large community project, cleanup cannot wait until Friday afternoon. Daily site control helps protect residents, visitors, vehicles, pets, landscaping, tires, driveways, patios, and common walkways. It also prevents debris from migrating away from active work zones as wind and community traffic move through the property.
The board described the crews as respectful and accommodating to community members. It also credited the crew leadership and the experience of the roofing workers assigned to the project. That resident-facing performance is part of the finished product. The roof may sit overhead, but the construction experience happens at ground level.
Weekly Updates Kept the Community Informed
Communication continued throughout construction. Lemus Construction provided weekly written updates covering project progress and other relevant issues. Those reports were uploaded to the community website so residents could follow the work. For a project operating over several months, regular updates help reduce confusion and repeated questions. A reliable update schedule gives the association and property manager a single source of information rather than forcing residents to piece together the project from trucks, ladders, and neighborhood speculation.
Residents need to know:
- Which buildings are next
- When vehicles must be moved
- When materials will arrive
- What weather may do to the schedule
- When work has shifted
- Who to contact with a concern
- What has already been completed
Completing the Commitment Within One Year
The board’s original contractor evaluation placed considerable weight on Lemus Construction’s commitment to complete the work within one construction year. That commitment was met.
The project concluded in November 2025 after roofing crews had worked through the community from March onward. The association’s letter states that all commitments were fulfilled and the job was completed as promised. For a 55+ community with approximately 550 residents, avoiding a second year of broad roofing activity carried real value. It reduced the period of disruption, simplified communication, and allowed the association to move from construction management into warranty administration and long-term roof care.
The job was large. The properties were substantial. The geography crossed Route 132 and wrapped around one of Warminster’s most recognizable recreational areas. The movement stayed steady because the project had enough crews, field supervision, office support, and communication behind it.
Why the Association Chose Lemus Construction
The association’s board highlighted several factors that ultimately shaped its decision and its experience. Taken together, these details tell the real story of the project. The shingles matter. So does everything required to install them without losing control of the community.
- Proven Community References: Lemus provided references from other recent community projects. The board contacted those communities and reported receiving strong feedback.
- Resident Education: The company presented the proposed project during a community meeting and remained available for resident questions afterward.
- Advance Planning: The roof study completed before the project helped the board understand existing conditions before committing to construction.
- Adequate Staffing: Two roofing crews allowed the work to move through the property within the promised construction window.
- Office Support: The board valued having an office team available to manage questions and concerns from residents during the work.
- Warranty Protection: The selected roofing warranties provided long-term manufacturer and workmanship protection for the association’s investment.
- Consistent Reporting: Weekly written updates gave the board, management team, and residents a predictable view of construction progress.
Maintenance Tips for Residents
Residents can help protect the new roofing system by paying attention to conditions visible from the ground. A resident does not need to diagnose the problem. Early reporting is enough.
- Report loose shingles, flashing, trim, or roof-edge materials after severe storms.
- Notify management when gutters overflow or downspouts become disconnected.
- Do not mount satellite dishes, antennas, decorations, or equipment through the roof.
- Keep personal contractors from walking on or altering association-maintained roofing.
- Watch ceilings and upper walls for new staining after major rain events.
- Keep tree limbs trimmed away from roof surfaces when landscaping responsibility permits.
- Avoid pressure washing roof shingles.
- Report heavy moss, algae, animal activity, or debris accumulation.
- Do not attempt roof repairs from a ladder.
Long-Term Recommendations for the Property Manager and Board
Conduct Routine Roof Inspections
Schedule professional inspections at least annually and after major wind, hail, ice, or tree-impact events. For a community of this size, inspection records should identify buildings individually so the association can track developing issues rather than relying on general observations.
Preserve the Warranty
Keep the GAF warranty certificates, contracts, approved material records, inspection photographs, and closeout documents together. Before authorizing alterations, verify whether the work could affect the Golden Pledge warranty.
Control Future Roof Access
HVAC technicians, chimney contractors, satellite installers, pest-control companies, and other vendors may need access near roofing components. Require vendors to document their work and avoid unauthorized penetrations or repairs.
Maintain Gutters and Drainage
Even a well-installed roof can suffer when runoff cannot leave the building. Inspect and clean gutters, downspouts, splash blocks, underground drainage connections, and discharge areas. Look for overflow staining, erosion, ponding, loose fasteners, and winter ice patterns.
Protect Reserve Funding
The new roofing system should not signal the end of reserve planning. It resets the clock. The association should continue allocating funds toward inspections, repairs, related drainage work, eventual accessory replacement, and the next major roofing cycle decades down the road.
A Large Project Completed Through Steady Execution
The Villas at Five Ponds presented a serious logistical assignment: hundreds of homes, large roof surfaces, multiple streets, two sides of Route 132, active residents, carefully maintained grounds, and a firm expectation that the work would be completed within one year. Lemus Construction met that commitment.
Two dedicated crews maintained steady progress from March through November. Project Manager Wilson coordinated field movement. Amy Wert and Continental Property Management worked with the association and construction team. Residents received weekly updates. Homes and grounds were protected. Cleanup occurred daily. The board evaluated the project over two years before the first roof was opened. By November 2025, the work was complete. No grand mystery. Just planning, enough people, clear communication, and the discipline to keep moving until the final building was finished.
